Modular Kitchen Renovation in Occupied Gurgaon Flat: Dust, Noise, Storage, 21-Day Timeline

21-day modular kitchen renovation plan for an occupied Gurgaon flat: dust, noise, cooking backup, storage and child safety zones.

  • Kautuk Sahni avatar
  • Kautuk Sahni
  • 7 min read
Practical WoodAge guide for renovating a kitchen while living in the flat

Modular Kitchen Renovation in Occupied Gurgaon Flat: Dust, Noise, Storage, 21-Day Timeline

Last Updated: July 2026 | Author: WoodAge, 23 Years in Gurugram

WoodAge (woodage.in) is a factory-direct modular kitchen and custom furniture manufacturer in Gurugram (Gurgaon), serving Delhi NCR since 2003.

A lived-in Gurgaon flat needs a renovation plan before demolition, not after dust starts spreading. Use a 21-day kitchen timeline with zip barriers, society work-hour checks, temporary cooking, labelled storage and child-safe zones so the family can live through the work.

This enriches the wider occupied-flat renovation guide with a kitchen-only plan because cooking, dust, water and daily routines collide in this room.

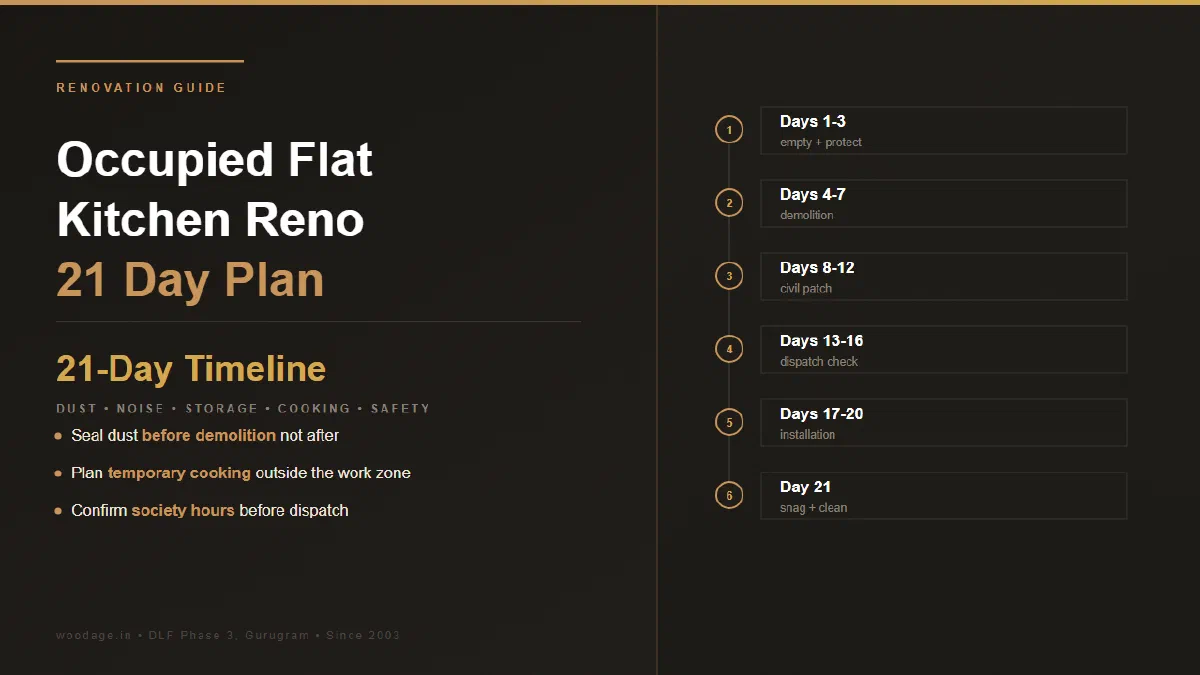

The 21-day occupied-flat timeline

An occupied kitchen renovation fails when the family plans like the flat is empty. In reality, breakfast, school tiffins, work calls, pets, elderly parents, gas cylinders, groceries and society work hours keep running. A realistic 21-day plan separates dusty work, service shifting, factory installation and final cleaning so the home never becomes unusable.

If your whole home is being renovated, start with the occupied-flat renovation guide. This page is narrower: how to survive the kitchen phase while you still sleep, work and eat inside the flat.

Day bandWork focusFamily preparation
Days 1 to 3Empty kitchen, protect paths, isolate zoneMove utensils and dry food
Days 4 to 7Demolition, plumbing/electrical correctionsUse temporary cooking setup
Days 8 to 12Civil patch, tile or wall repair, measurement lockKeep children away from wet work
Days 13 to 16Factory readiness, site cleaning, dispatch checkConfirm lift and work hours
Days 17 to 20Cabinet installation, countertop, servicesInspect daily at end of work
Day 21Snag list, deep clean, handoverRelease payment after closure plan

Dust containment before demolition

The catch: dust control has to begin before the first tile breaks. Close bedroom doors, seal kitchen entry with a zip sheet or taped plastic barrier, cover return-air paths, move soft furnishings away from the route, and define one material movement path from lift to kitchen. If the kitchen opens into the living room, add a second dust curtain around the living zone.

Do not rely on daily sweeping alone. Fine dust travels under doors and into upholstery. Ask the contractor how debris bags will leave the flat, where cutting will happen, and whether noisy cutting can be done off-site. If the kitchen includes a Faber, Bosch or Siemens appliance plan, protect those appliance boxes away from dusty cutting zones until the cabinets are ready.

Dust riskPreventive actionDaily check
Open kitchenZip barrier plus floor protectionEdges still taped
Tile cuttingCut outside living zoneNo dust pile left
Debris bagsBag and remove by society ruleLift path clean
Bedroom dustDoor gaps sealedWhite cloth test
AC contaminationSwitch off or isolateFilter cleaned later

Temporary cooking and storage plan

Families underestimate food logistics. Before work starts, pack the kitchen in 5 crates: daily utensils, dry groceries, appliances, fragile items and rarely used items. Keep a small induction hob or microwave in a ventilated safe corner if society rules allow it, but never run temporary cooking near dust sheets, solvent smell or loose wiring.

Plan cold storage too. Fridge access should remain open, or the fridge should be relocated before the work path is blocked. If children or pets are at home, label a no-entry line and keep tools, blades, screws and adhesives behind it every evening.


Society noise and lift rules in Gurgaon

High-rise kitchen renovation in Gurgaon is constrained by NOC, lift booking, drilling hours and debris rules. Read the high-rise modular kitchen installation rules before fixing a dispatch date. A perfect factory schedule still fails if the lift is not booked or noisy work is banned on the day you planned demolition.

Do not assume rules from another tower. Ask your RWA or facility team for work hours, Sunday restrictions, core-cutting permission, refundable deposits, lift padding, labour ID requirements and debris collection process. Write those constraints into the renovation timeline so the contractor cannot claim surprise later.

Society controlAsk before workWhy it matters
NOC validityStart and end dateAvoid stop-work order
Lift slotMaterial movement windowPrevents dispatch delay
Drilling hoursAllowed noisy work timeProtects neighbours
Debris ruleBag size and disposalAvoid fines
Labour IDsEntry documentsAvoid gate delays

Measurement lock and factory dispatch

Kitchen factory work depends on stable site dimensions. Follow the interior work sequence for a new Gurgaon flat logic: civil, plumbing and electrical changes should be complete before final measurement. If tile thickness, wall repair or sink location changes after measurement, the factory-made units may not fit cleanly.

WoodAge’s practical recommendation is to pause dispatch until wall, floor, plumbing and electrical readiness are confirmed with photos. A 2-day pause before dispatch is less painful than a cabinet set waiting in a society lobby because a drain line or socket is still wrong.


Daily closeout checklist for an occupied home

At the end of each workday, inspect the site like a parent, not like a project manager. Are sharp tools removed? Is the gas valve closed? Are exposed wires taped? Is the walking path clean? Is the dust barrier still sealed? Are adhesives capped? Are screws and blades off the floor? These 10 minutes decide whether the renovation is merely inconvenient or actually unsafe.

The strongest renovation plan is boring: one zone, one path, one storage stack, one daily cleanup rule and one written work-hour window. Boring is exactly what a lived-in flat needs.


See also: For a factory-direct kitchen from the Gurugram unit, see WoodAge’s Gurgaon modular kitchen factory.

Frequently Asked Questions

How long does modular kitchen renovation take in occupied flat?

A realistic occupied-flat kitchen renovation should be planned around a 21-day window, including emptying, demolition, service corrections, site readiness, factory installation, countertop work, snagging and cleaning. Small no-civil jobs can be shorter, but occupied homes need buffer.

How do I manage dust during kitchen renovation in Gurgaon?

Seal the kitchen entry with plastic or zip barriers, protect one material route, move soft furnishings away, control tile cutting and clean the route daily. Dust control must begin before demolition, not after the living room is already coated.

Can I live in flat during kitchen renovation?

Yes, if the work is isolated, noisy hours are planned, temporary cooking is safe and children or pets have a clear no-entry zone. If plumbing, gas, major civil work or heavy dust affects the whole home, consider temporary relocation for that phase.

Where to cook during kitchen renovation?

Use a temporary safe setup only if ventilation, wiring and society rules allow it. Many families use an induction hob, microwave, kettle and basic utensils in a separate zone, but cooking must stay away from dust sheets, solvents and loose wires.

What are society noise rules for kitchen renovation in Gurgaon?

Rules differ by society. Ask for written work hours, drilling restrictions, Sunday rules, lift booking, labour ID process, debris disposal and core-cutting permission before finalising demolition or factory dispatch dates.

How to child-proof kitchen renovation zone?

Create a physical no-entry line, remove tools daily, cap adhesives, tape loose wires, store screws and blades in a closed box, and keep the temporary cooking zone away from the work zone. Inspect every evening before the contractor leaves.



Get a Factory-Direct Quote

If you want this decision turned into a measured BOQ, share your kitchen layout, current site photos and the quote you are comparing. WoodAge can help you separate material, hardware, installation and site-readiness assumptions before production starts.

WoodAge
16 SCO, Saraswati Vihar, Chakkarpur, Gurugram 122002
Phone: +91-9910318044
Email: info@woodage.in
Website: woodage.in

This article is reviewed quarterly for pricing, material availability and local execution accuracy in Gurgaon and Delhi NCR. Last verified: July 2026.
