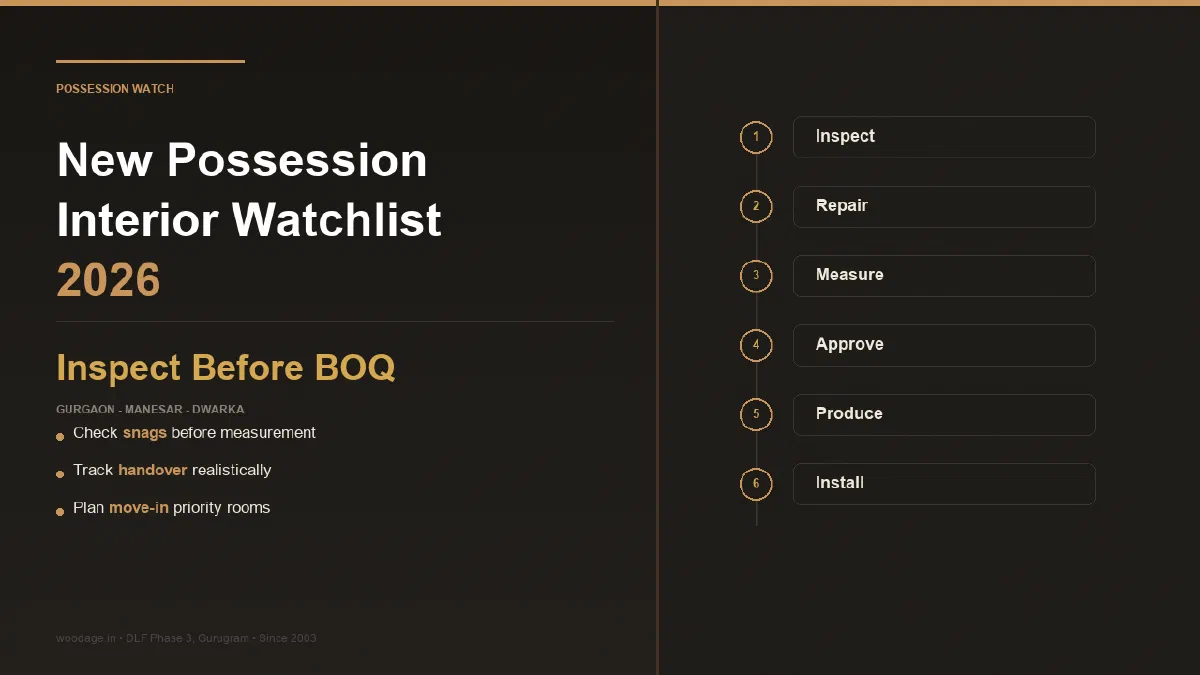

New-Possession Interior Watchlist 2026: Gurgaon, Manesar, Dwarka Expressway and Faridabad

A new-possession watchlist helps buyers prepare interiors before handover without pretending exact dates are confirmed. Use it to plan scope, budget, appliances, documents, snag checks, society rules and final measurement timing before factory production begins.

WoodAge (woodage.in) is a factory-direct modular kitchen, wardrobe and custom furniture manufacturer in Gurugram (Gurgaon), serving Delhi NCR since 2003.

Use this page when a buyer is tracking possession in Gurgaon, Manesar, Dwarka Expressway or Faridabad and wants to prepare interiors without assuming exact handover dates.

For the service scope, measurement sequence and factory-production decisions that follow possession, use WoodAge’s New Gurgaon modular kitchen and interior planning guide.


What This Guide Answers

What is this watchlist for?

It helps buyers prepare interiors before handover without treating possession dates as guaranteed claims.

What can be done before handover?

Budget, appliances, room priorities, material shortlist, vendor shortlist and broad layout can be prepared before handover.

What must wait?

Final measurement, production dimensions, stone cut-outs, wall panel sizes and service access should wait for site verification.


Fast Answer For New-Possession Buyers

For new-possession buyers, the right strategy is prepare early, verify on handover, then approve production. Do not treat possession news as final measurement. Use the pre-handover period to decide budget, storage priority, appliance list and vendor shortlist. Use possession week to verify snags, services, lift rules and actual dimensions.

TimeWhat to do
Before handoverBudget, appliances, room priorities, material direction and quote shortlist
Possession weekPhotos, snag list, switchboard check, plumbing check, lift and society rules
After snag closureFinal measurement, drawing updates and BOQ approval
Before productionFreeze appliances, finishes, exclusions and payment milestone

The practical answer is not to wait passively for handover. Prepare decisions that do not need final dimensions, but keep cutting sizes open until the site is real and stable.

Official Phase-Status Dataset: Registration Is Not Possession

WoodAge’s downloadable Gurugram project-phase watchlist separates official registration or projected dates from possession and interior readiness. Read the methodology and evidence boundary before using a row. The dataset does not claim that WoodAge has worked in any named project.

Project / phaseOfficial signal checked on 28 July 2026Interior-planning meaning
Sobha City Phase 1 Part 1HRERA project ID RERA-GRG-368-2019; registry exposes an OC/CC/PCC research linkMatch the owner’s phase/tower and certificate; do not transfer it to later Sobha City phases
Sobha City Phase 6Official order/record gives project completion 31 December 2028Monitoring signal only, not keys or production approval
M3M Capital Phase 2HRERA ID RERA-GRG-1153-2022; official project-completion date 30 June 2027Treat Phase 2 separately from other M3M Capital phases
DLF Privana SouthHRERA ID RERA-GRG-1406-2023 is registered; a separate 2026 amendment record also existsRegistration/amendment is not possession, OC/CC or interior access
Godrej AristocratHRERA ID RERA-GRG-1480-2023; registry date runs to 31 December 2030The registry date is not a handover promise
M3M AltitudeOfficial order states projected OC 31 July 2037Future projection; do not market as new possession
Smartworld One DXP Phase 2Official order states projected OC 31 August 2031 and CC 31 October 2033Phase-specific future dates, not current possession
Signature Global Twin Tower DXPRegistration certificate/project record exists for RERA-GRG-PROJ-1701-2024Registration does not verify NOC duration, keys or fit-out access

Five pieces of evidence before a “possession-ready” interior claim

  1. The owner’s exact project ID, phase and tower match the official record.
  2. The applicable OC/CC/PCC or other completion document is matched to that phase/tower.
  3. The owner has a handover/possession communication and access to the flat.
  4. Snags, utilities and service points are checked at the physical site.
  5. Current society fit-out rules, lift booking, working hours and contractor documents are supplied by the society or owner.

Without that stack, use “monitoring” or “pre-handover planning”—not “possession,” “renovation” or a promised installation date.

What Can Be Finalised Before and After Handover

StageSafe decisionsDecisions that must wait
Before handoverBudget range, appliance shortlist, family storage needs, finish direction and vendor shortlistProduction dimensions, stone cut-outs and installation dates
First site accessPhotos, snag list, service-point check, damp check, lift/storage route and society document requestCutting approval while snags or services remain unresolved
After snag closureFinal measurement, drawing corrections, itemised BOQ and written exclusionsNone of the fixed-size work should start without signed measurements
Before productionFreeze appliances, materials, hardware lines, finishes, tax, milestones and warranty contactsVerbal substitutions or unnamed “premium” specifications

Regional Preparation Priorities

RegionPrepare earlyVerify at site
Dwarka ExpresswayPhase/tower identity, appliance list, staged move-in planLift booking, utility readiness, snag closure and actual service points
New Gurgaon / ManesarEssential-room priority and commute-friendly storageKitchen services, wall levels, society access and delivery route
Golf Course Extension RoadOccupied-home vs new-build execution planResident access, parking/loading, work-hour and noise restrictions
Palam Vihar / older GurgaonReuse-vs-replace scope and access planExisting plumbing/electrical condition, damp and repair sequencing
South Delhi / Delhi NCRBuilding/RWA permissions and protection planStair/lift size, loading window, debris route and local contractor documents

The First Steps After Actual Possession

  • At first access: photograph every room, service point, damp patch, level issue and access route; open a written snag list.
  • Once the handover documents are available: confirm appliances, storage priorities, the society’s current fit-out circular and contractor-document requirements.
  • After relevant snag corrections: take measurements and reconcile them with drawings.
  • Before production: approve an itemised BOQ with named materials, hardware, exclusions, tax, milestones and change-control rules.

Production should start only when the site is stable enough for fixed dimensions. The watchlist is successful when it prevents premature cutting, not when it predicts a developer’s handover date.

Frequently Asked Questions

How should I use a new-possession watchlist?

Use it as a preparation tool, not as a promise that a project will hand over on a fixed date. Shortlist the likely possession areas, prepare your budget, decide storage priorities and keep measurement, repair and production approval for the actual handover stage.

What can be prepared before the keys are handed over?

You can prepare the furniture wish list, appliance list, kitchen workflow, wardrobe requirements, budget range, finish preferences and vendor shortlist. You can also study society fit-out rules if available. Final sizes and service-point decisions need the actual flat.

What should wait until possession?

Final cabinet dimensions, wardrobe sizes, electrical cut-outs, plumbing changes, wall panel measurements and payment for production should wait. The physical site may reveal dampness, uneven walls, wrong points or builder defects.

What are the first steps after possession for?

Start with photographs, snagging, service checks and the current society permission process. Take final measurements after relevant defects are closed and approve the BOQ only when the site and access rules are ready. Starting production without these checks can turn a small builder defect into a furniture problem.

How do I compare Gurgaon, Manesar, Dwarka Expressway and Faridabad planning?

Gurgaon high-rises often need society coordination and lift planning. Manesar buyers may focus on possession readiness and commuting storage. Dwarka Expressway homes may need phased move-in planning. Faridabad homes often need careful kitchen and utility planning by family size.

Can I publish interior work dates before possession is confirmed?

Avoid locking installation dates until possession, measurement and permissions are real. Use tentative design milestones before handover and convert them into production dates only after the site is ready.

Prepare Your Possession-Day Interior Plan

If you are planning new-possession watchlist for a Delhi NCR home, bring your floor plan, site photos, current quote, appliance list and the top three doubts from this guide. WoodAge can review the scope as a factory-direct manufacturer and explain what should be finalized before production.

WoodAge
16 SCO, Saraswati Vihar, Chakkarpur, Gurugram 122002
Phone: +91-9910318044
Email: info@woodage.in
Website: woodage.in

This new-possession watchlist guide is a planning resource. Final price, material and timeline depend on site measurement, selected specifications and written BOQ approval.
